How to Choose a Dynamics 365 Implementation Partner: A 10-Point Vendor Scorecard

Rohit Dabra Rohit Dabra | Updated on September 10, 2026
How to choose a Dynamics 365 implementation partner using a 10-point vendor scorecard
Summarize in:
Get an instant AI summary of this article

Introduction

To decide how to choose a Dynamics 365 implementation partner, score every bidder against the same business, technical, delivery, governance, adoption, commercial, and support criteria. Apply mandatory pass/fail gates first, require evidence for every score, and put the winning commitments into the contract and statement of work. This approach makes selection less dependent on badges, presentation quality, or a salesperson’s confidence.

The decision falls apart if the product, proposed team, or contract is a poor fit. The Microsoft product mix has to support the operating model. The people named in the proposal have to be able to deliver it, and the commercial agreement has to keep the work inspectable and controllable.

The framework below gives a buying committee a 100-point Dynamics 365 implementation partner scorecard. The weights are a starting point, not an industry law. Adjust them before proposals arrive, preserve the same rules for every bidder, and record the evidence behind every judgment.

In this article, you'll learn
  • How to define your implementation before asking partners to price it
  • How to apply knockout conditions and a consistent 0–5 scoring scale
  • What to assess, request, and challenge across ten weighted criteria
  • Which RFP questions, scenario demos, and reference checks reveal delivery risk
  • How to convert sales promises into an enforceable Dynamics 365 implementation SOW
In This Article, You'll Learn
  • Start with a one-page buyer brief
  • How to choose a Dynamics 365 implementation partner with a 100-point scorecard
  • Apply pass/fail gates before weighted scoring
  • The 10-point Dynamics 365 partner selection scorecard
  • Build the shortlist in seven controlled stages

Eager to discuss about your project?

Share your project idea with us. Together, we’ll transform your vision into an exceptional digital product!

Book an Appointment now

Start with a one-page buyer brief

Do not begin partner selection with a generic request for "Dynamics 365 implementation services." Bidders will fill the gaps differently, then submit proposals that cannot be compared fairly. A concise buyer brief creates a common starting line without pretending that discovery is already complete.

Document the business outcomes and process problems to solve; in-scope legal entities, business units, countries, users, and process areas; likely Dynamics 365 applications; material non-Microsoft systems; data sources and known quality problems; security, privacy, residency, audit, and regulatory constraints; the required go-live window; internal subject-matter expert availability; decision rights; post-launch support expectations; and explicit exclusions. If the organization is prepared to disclose a budget range or commercial constraint, state it in the same terms for every bidder.

Separate product fit from partner fit

A credible partner should challenge a poor product or scope assumption. If Finance, Supply Chain Management, Sales, Customer Service, Field Service, Project Operations, Power Platform, analytics, Azure integration, or third-party products are still undecided, product selection may need a dedicated discovery step. Do not reward a bidder for forcing every requirement into whichever module it sells most often.

The brief should also explain the current state in operational language. Describe handoffs, exceptions, controls, bottlenecks, recurring workarounds, and the systems of record. If your immediate focus is CRM, the Dynamics 365 CRM implementation phases guide can help the team frame the work from discovery through support. For sales-process context, review these Dynamics 365 CRM automation examples and identify which workflows matter in your environment.

How to choose a Dynamics 365 implementation partner with a 100-point scorecard

Use a 0–5 raw score for each criterion. A score of 0 means no response or unacceptable risk. A 1 indicates assertions with major gaps. A 2 reflects partial fit supported by weak or indirect evidence. A 3 means the bidder meets the requirement with credible evidence. A 4 indicates strong fit, detailed evidence, and low residual risk. A 5 should be rare: exceptional fit for this specific program, verified proof, and clear additional value.

Calculate weighted points with this formula: raw score ÷ 5 × criterion weight. Evaluators may use half-points only when they can explain the distinction in writing. Each score needs a source, such as a proposal page, named artifact, scenario observation, reference-call note, contract clause, or written clarification. Record confidence separately as high, medium, or low. A high score based on an unverified promise is not equivalent to a high score backed by inspectable work and contract language.

Ask business, functional, technical, security, procurement, and operations evaluators to score independently before a consensus meeting. This reduces group anchoring and exposes different interpretations of the same response. Lock weights before opening bids. If the team later discovers that a weight is wrong, document approval for the change and apply it to all candidates.

#CriterionWeight
1Business-process and outcome fit14
2Dynamics 365 product and solution architecture fit13
3Discovery, requirements, and scope control11
4Data migration, integration, and technical engineering12
5Security, compliance, environments, and governance10
6Delivery method, transparency, and quality assurance10
7Delivery team capability, capacity, and continuity9
8Adoption, training, and organizational change8
9Commercial clarity, price realism, and contract alignment8
10Support, operability, and exit readiness5
 Total100
Dynamics 365 implementation partner 100-point scorecard matrix - how to choose a dynamics 365 implementation partner
Score each bidder against the same ten criteria and preserve the evidence behind every rating.

Apply pass/fail gates before weighted scoring

A high total must not hide a failed mandatory condition. Define knockout gates around the risks that your organization cannot accept. These might include required confidentiality, data-processing, security, and compliance terms; data-residency and privileged-access controls; disclosure of subcontractors and delivery locations; customer access to data, configuration, code, documentation, and agreed deliverables; availability of named critical staff; mandatory insurance or procurement requirements; participation in a scenario workshop and relevant reference calls; disclosure of assumptions and third-party products; and a workable transition or exit approach.

Keep these gates outside the 100 points. A bidder either passes, fails, or receives a formally approved exception with a named risk owner and written mitigation. Never bury a legal, security, data, or continuity veto inside an average. The score ranks capable candidates; it does not authorize the team to ignore a non-negotiable requirement.

The 10-point Dynamics 365 partner selection scorecard

1. Business-process and outcome fit: 14 points

Assess whether the partner understands your target operating model rather than translating a feature list into a module list. The team should be able to map the relevant end-to-end processes, such as lead-to-cash, case-to-resolution, procure-to-pay, plan-to-produce, or record-to-report. Look for process owners, controls, exceptions, cross-functional dependencies, and outcome measures. Industry familiarity helps, but comparable process complexity, geography, regulation, and operating constraints are more informative than a matching industry label.

Request an anonymized process map, fit-to-standard output, requirements traceability matrix, or design excerpt. Ask the bidder to interpret your three largest process risks in writing. For project examples, require the scope, complications, lessons, proposed team members’ roles, and evidence that the comparison is relevant. A useful outcome register identifies the baseline, target, owner, measurement method, and review cadence instead of declaring go-live itself a benefit.

Red flags include a product-module pitch with little discussion of operations, agreement with every requirement before discovery, customization proposed before standard process options are considered, and success defined only as on-time or on-budget launch. A raw 3 means the bidder understands priority processes and supports that understanding with relevant evidence. A 5 connects process design, controls, adoption, and measurable outcomes while identifying material risks the buyer has not resolved.

2. Dynamics 365 product and solution architecture fit: 13 points

Evaluate the proposed boundaries across Dynamics 365, Power Platform, Azure, Microsoft 365, data and analytics services, and third-party products. The architecture should explain where configuration ends, where extension or integration begins, and why any custom development is justified. It should also address identity, environments, data ownership, interfaces, analytics, nonfunctional requirements, application lifecycle management, upgradeability, service limits, and technical debt.

Ask for a solution-context diagram based on your scenario, a sample architecture decision record, the proposed design-authority model, a fit-gap example, and a preliminary environment and release topology. If Power Apps or Power Automate forms part of the design, compare the proposal with your broader Power Platform development and governance needs. Licensing assumptions should be explicit and identified for validation rather than presented as unconditional promises by the implementation team.

Watch for a box labeled "integrations" with no interface ownership or failure behavior; vague "out of the box" claims that conceal process compromises; custom code that recreates available capability without a reason; and no policy for source control, managed solutions, deployment, or solution layering. A 3 represents a coherent, supportable architecture with stated assumptions. A 5 requires disciplined trade-offs, traceability, lifecycle considerations, and governance across the Microsoft stack.

3. Discovery, requirements, and scope control: 11 points

Discovery should convert uncertain goals into decisions, validated scope, and a delivery backlog. Score the planned participants, workshops, outputs, decision rights, and validation method. Look for traceability from business outcome to process requirement, backlog item, design, test, and acceptance. The proposal should distinguish assumptions, dependencies, exclusions, nonfunctional requirements, and deferred work, then explain how each is owned and resolved.

Request a sample discovery plan and deliverables list, an anonymized dependency and decision log, a traceability matrix, definitions of ready and done, and the acceptance workflow. Ask whether the buyer owns and can reuse blueprint outputs. A priced discovery phase can be sensible when critical decisions remain unresolved, but verify the exact deliverables, assumptions, reuse rights, and whether implementation estimates produced afterward are firm or still indicative.

Be wary of a fixed price built from a thin brief, workshops with no decision-grade outputs, assumptions without owners or deadlines, and change requests used for normal backlog refinement. Another warning is language that blurs an estimate, budget, and contractual commitment. A 3 indicates a repeatable process producing usable discovery and traceability artifacts. A 5 makes uncertainty visible early and ties scope, decisions, acceptance, and commercial effects together.

4. Data migration, integration, and technical engineering: 12 points

Data and integrations often expose assumptions that appeared harmless in a sales proposal. Assess profiling, cleansing ownership, mapping, transformation, reconciliation, retention, archival, rehearsals, cutover, and rollback. For every interface, identify source and target ownership, pattern, frequency, volume, latency, monitoring, error handling, recovery, and operational support. Include legacy constraints and third-party API limits rather than assuming every endpoint behaves as designed.

Microsoft describes migration as complex and time-consuming and recommends a staffed plan covering sources, targets, entities, volumes, methods, sequencing, dependencies, roles, and cutover activities. Its guidance also calls for migration verification at least once in both system integration testing and user acceptance testing environments. Ask bidders for a sample migration strategy, mapping workbook, reconciliation report, mock-cutover plan, integration catalogue, pipeline diagram, and responsibility matrix. See Microsoft’s data migration guidance for the source requirements behind these checks.

Red flags include leaving migration until the final phase, writing "customer to provide clean data" without profiling criteria, estimating interfaces without payload or load assumptions, and relying on manual production deployments with weak rollback controls. A 3 shows credible ownership, methods, and test evidence. A 5 adds repeatable rehearsals, business reconciliation, failure recovery, telemetry, and engineering controls proportionate to the program’s risk.

5. Security, compliance, environments, and governance: 10 points

"Microsoft handles security" is not an implementation plan. The platform provides capabilities, while buyer and partner decisions determine identities, privileges, role design, integrations, test data, custom components, environment access, and production-change authority. Assess least privilege, segregation of duties, service accounts, privileged administration, classification, privacy, retention, residency, encryption, audit, incident response, and secure development.

Request a security responsibility matrix, preliminary threat or risk assessment, role-design example, data-flow diagram with trust boundaries, development-security policy, incident process, and appropriate assurance reports. Governance artifacts should include design authority, decision rights, approval gates, risk acceptance, exception handling, and an audit trail. Microsoft recommends defining the project governance model early, preferably during initiation, covering measurable goals, organization, methodology, change, risk, design, testing, deployment, and planning. Its project governance guidance provides a useful baseline.

Shared administrator accounts, broad standing access, uncontrolled production data in lower environments, badge-based compliance claims, and partner-controlled credentials are clear warnings. A 3 maps controls and responsibilities to the buyer’s requirements. A 5 integrates security into design, approvals, evidence retention, deployment, and ongoing operation rather than scheduling one late review.

6. Delivery method, transparency, and quality assurance: 10 points

Method labels matter less than the controls they produce. Assess the cadence of usable increments, working-software demonstrations, testing, risk reviews, and steering decisions. Buyers should have direct visibility into the backlog, forecast, budget, defects, dependencies, decisions, and unresolved assumptions. Ask how the forecast changes when evidence changes. "Agile" is not permission to avoid dates, documentation, or accountability.

Request a sample delivery plan, status report, RAID log, test dashboard, defect-triage process, demo agenda, steering pack, and quality gates from design to production. Microsoft’s testing strategy guidance calls for scope tied to business processes and functional and nonfunctional requirements, explicit objectives and entry/exit criteria, tracked defects, and business sign-off before deployment. Confirm who owns unit, integration, system, regression, security, performance, user acceptance, migration, and cutover testing where each applies.

Slide-only status reporting, inaccessible work records, demos delayed until late testing, and UAT treated as the only quality control should reduce the score. A 3 provides regular reviews of working software, transparent records, and a complete quality plan. A 5 gives the buyer auditable visibility into decisions, quality, cost, forecast, and acceptance. QServices IT, for example, uses five human approval gates, weekly demos, architecture decision records, and fixed-scope sprints. Treat those as practices to verify in any bidder, not labels that deserve automatic points.

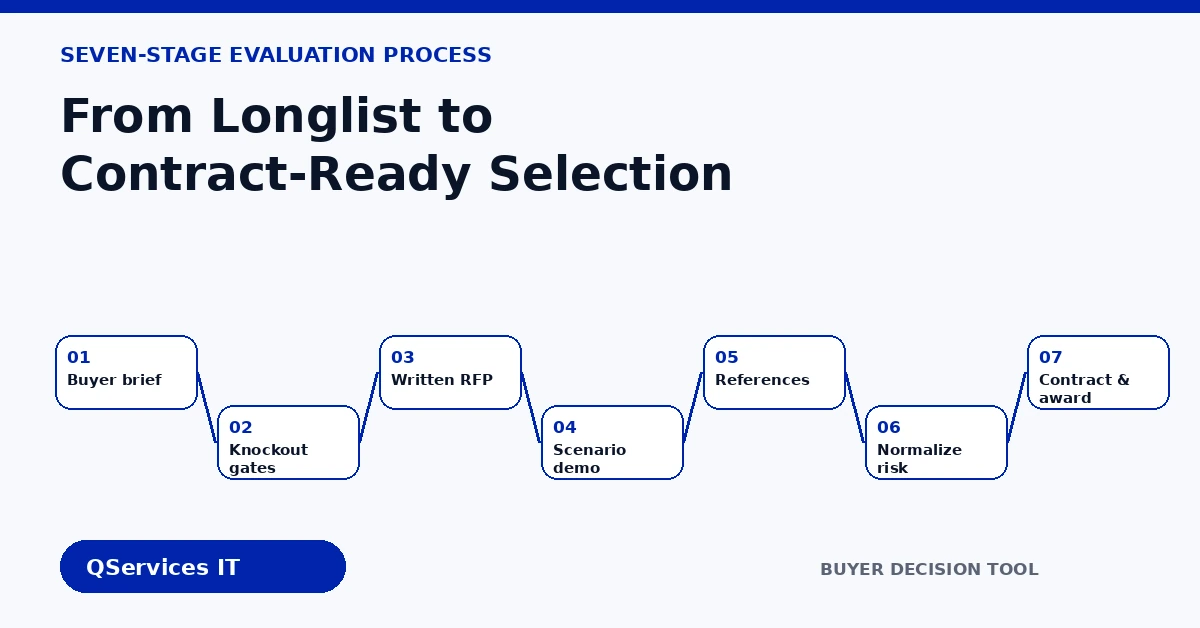

Dynamics 365 partner selection process from longlist through contract review - how to choose a dynamics 365 implementation partner
A staged selection process tests evidence before the preferred bidder receives an award.

Need a decision-grade scope before you compare Dynamics 365 bids?

Define the process, architecture, risks, assumptions, and acceptance criteria before pricing becomes a commitment.

Book a Blueprint Call

7. Delivery team capability, capacity, and continuity: 9 points

Score the people proposed for your work, not a corporate bench or representative résumé. The team needs relevant process and module depth, architecture and engineering competence, delivery leadership, communication ability, and enough capacity for the promised schedule. Review the balance between senior oversight and hands-on execution, along with locations, time zones, allocations, subcontractors, start dates, and competing commitments.

Require named critical staff with roles, allocation, location, employment or subcontractor status, availability, and relevant responsibilities on comparable projects. Interview the proposed solution architect, functional lead, technical lead, delivery lead, and change lead through working sessions. Ask for a resource-loading plan, succession approach, knowledge-transfer method, and substitution terms. Sales-stage experts should have a stated role after signature if their expertise influenced your evaluation.

Representative profiles, undisclosed subcontracting, one person assigned several incompatible full-time roles, and a unilateral right to replace staff with vaguely "equivalent" resources are warning signs. A 3 identifies an available team with role-specific evidence and continuity provisions. A 5 requires the actual team to perform strongly in scenarios and makes the staffing commitments contractible, including replacement approval and handover duties.

8. Adoption, training, and organizational change: 8 points

Adoption is a lifecycle workstream, not a set of generic product videos delivered before go-live. Assess stakeholder analysis, process and role impacts, communications, readiness, training, reinforcement, and ownership of adoption measures. The plan must account for accessibility, language, geography, shift work, frontline access, and the availability of business participants where these conditions apply.

Ask for a sample change-impact assessment, stakeholder map, readiness criteria, role-based curriculum, configured-environment training example, champion model, and hypercare communications plan. Determine who creates content, validates it, delivers training, tracks attendance, measures competence, and reinforces new behavior. Microsoft describes change management as fundamental and says it should match program risk and complexity across Initiate, Implement, Prepare, and Operate. Use its change management guidance to test whether the proposal covers the full lifecycle.

A small training line near launch, adoption measured only by logins, or a plan that ignores process, policy, incentives, and role changes indicates weak fit. A 3 provides role-based change and training connected to readiness. A 5 integrates business ownership, support readiness, feedback, measurable behavior, and post-launch reinforcement.

9. Commercial clarity, price realism, and contract alignment: 8 points

Normalize commercials before comparing totals. A low bid may assume unusually clean data, unlimited buyer availability, few interfaces, minimal testing, or exclusions that another bidder priced. Require costs by phase, workstream, role, and deliverable, together with effort assumptions, buyer obligations, contingency, expenses, licensing dependencies, environments, migration tools, ISV products, travel, support, taxes, and optional work.

Match the pricing model to uncertainty. Fixed price can work when scope, assumptions, dependencies, acceptance, and change control are clear. Time and materials can fit discovery or evolving backlogs when burn, forecast, caps, priorities, and decision rights are visible. A hybrid may separate discovery from implementation or price accepted increments. Request a price workbook, rate card, assumptions and exclusions register, sensitivity analysis for unresolved variables, change-order workflow, and an invoice example tied to accepted outputs.

Large upfront payments, material "TBD" items hidden behind a firm total, expiring discounts that constrain diligence, and broad change rights paired with vague fixed-price language should reduce the score. A 3 traces price to scope and exposes major total-cost components. A 5 allocates uncertainty rationally and connects payment to acceptance and enforceable change controls. QServices publishes a $5,000 five-day Blueprint Sprint and a $15,000 Project Sprint lasting 15–45 days. These are packaged QServices offers, not market benchmarks; a buyer should still verify scope, outputs, dependencies, reuse rights, and acceptance.

Key Insight QServices publishes a $5,000 five-day Blueprint Sprint and a $15,000 Project Sprint lasting 15–45 days.

10. Support, operability, and exit readiness: 5 points

The smallest weight still covers consequences that last beyond go-live. Evaluate hypercare, warranty, steady-state service hours, severity definitions, response and restoration targets, escalation, monitoring, runbooks, release management, environment administration, recurring tasks, and the boundary between defect remediation and paid enhancement. The intended support model should influence architecture and documentation before production.

Request a support catalogue, service-level schedule, sample runbook, monitoring view, handover checklist, known-error record, documentation inventory, and exit plan. Confirm that the customer can access configuration, code, source control, pipelines, credentials, test assets, decision records, and current documentation. Transition terms should state time, rates, deliverables, export formats, access revocation, data return or deletion, and cooperation with an internal team or replacement supplier.

Partner-controlled accounts, stale documentation, ambiguous warranty boundaries, and exit assistance at undefined future rates create avoidable lock-in. A 3 provides an operable support and transition model. A 5 minimizes dependency through tested handover, customer-controlled assets, measurable commitments, and clear exit duties.

Build the shortlist in seven controlled stages

  1. Form the buying team and rules. Name the sponsor, evaluation lead, process owners, architecture, security, data, operations, procurement, finance, and legal participants. Agree gates, weights, scoring rules, conflicts, and decision authority before vendor contact.
  2. Create a focused longlist. Use directories, referrals, and prior experience as discovery inputs. Check product and process relevance, geography, capacity, commercial fit, and willingness to provide evidence.
  3. Run a concise RFI. Send the same buyer brief and knockout questions to all candidates. Ask for named-team availability, delivery locations, subcontractors, relevant examples, and an indicative commercial approach.
  4. Issue the RFP and data room. Give shortlisted vendors identical baseline information. Run a controlled clarification log so every bidder receives material answers. State how responses, scenarios, references, security diligence, and commercials will be scored.
  5. Use a buyer-authored scenario. Ask the proposed team to work through a realistic cross-functional process, exception, integration failure, security decision, scope dispute, and cutover risk. A canned demo cannot show how the team handles your ambiguity.
  6. Validate and normalize. Inspect artifacts, check references, reconcile exclusions, compare like-for-like price, and move clarifications into the proposal or draft SOW. Re-score only when new evidence warrants it.
  7. Select subject to contract. Keep a reserve bidder. Do not announce a final award until material scope, data, security, IP, support, liability, and staffing terms are agreed.

Microsoft partner designations can help form a longlist, but they do not remove diligence. Microsoft says the Solutions Partner for Business Applications designation demonstrates broad capability across Dynamics 365 and Power Platform. Its current capability score requires at least 70 of 100 points and at least one point in five metrics covering customer additions, certifications, usage growth, and deployments. Those measures combine performance, skilling, and customer success; they do not prove that your proposed delivery team fits a specific project. Verify the current criteria in Microsoft’s Business Applications designation documentation.

Dynamics 365 implementation statement of work checklist - how to choose a dynamics 365 implementation partner
The scorecard only works when selection-critical promises survive contract and SOW review.

RFP questions that force comparable answers

Require each bidder to answer in the same structure and cite the proposed artifact or contract section that supports the answer. These questions are designed to expose assumptions rather than produce long marketing narratives.

  1. Restate our three priority outcomes. Which design or adoption decisions could prevent each one?
  2. For the supplied process, what would you configure, extend, integrate, buy from an ISV, or leave outside Dynamics 365, and why?
  3. Which Dynamics 365 applications and adjacent services do you propose? Which product and licensing assumptions require validation?
  4. What decisions will discovery resolve, who must participate, and which reusable deliverables will the customer own?
  5. Show how an outcome becomes a process requirement, backlog item, design decision, test, and acceptance record.
  6. Explain data profiling, cleansing ownership, migration rehearsals, reconciliation, rollback, and business sign-off.
  7. List assumed integrations, volumes, frequencies, dependencies, monitoring, and failure ownership.
  8. Define responsibility for identity, roles, privileged access, test data, audit, incidents, and production changes.
  9. Explain source control, solution management, automated checks, deployment, segregation, rollback, and release approval.
  10. What can the buyer inspect weekly across working software, backlog, budget, forecast, defects, risks, decisions, and dependencies?
  11. Which test levels are included, who owns them, what entry and exit criteria apply, and what evidence is retained?
  12. Name critical staff, allocations, locations, availability, subcontractor status, and substitution terms.
  13. How will you identify change impacts, train users in the configured system, prepare support, and measure adoption?
  14. Identify assumptions, exclusions, buyer duties, third-party costs, optional work, and events that change price or schedule.
  15. Define hypercare, warranty, support boundaries, documentation, knowledge transfer, customer-controlled assets, and termination help.
  16. Describe a relevant delivery problem that forced a forecast, scope, or design change. What was disclosed and documented?
  17. Provide references with comparable process and technical complexity, identifying which proposed staff participated.

Verify the proposal through scenarios and references

In a scenario workshop, observe who asks clarifying questions before proposing a solution. Can the team explain trade-offs and constraints? Can it move from process discussion to architecture, security, delivery, testing, and acceptance? Does it record unresolved assumptions, or smooth them over to keep the meeting comfortable? The quality of collaboration among the named team and buyer stakeholders matters because those people will make difficult decisions together after contract signature.

For references, establish the original scope and what materially changed. Ask which proposed team members worked on the implementation, what surprised the customer in data, integrations, adoption, cost, or schedule, and how transparent the partner was about forecasts, defects, decisions, and change orders. Ask what remained unresolved at go-live, how support and knowledge transfer performed, and what the customer would contract differently. Validate that the reference resembles your process and technical complexity. Obtain permission before informal back-channel outreach.

Convert sales promises into an enforceable Dynamics 365 SOW

The scorecard cannot repair a vague statement of work. Every promise that affected selection should be incorporated into the contract or expressly referenced. Legal, security, procurement, and delivery specialists should review terms for the organization’s jurisdiction and policies; the checks below are operational guidance, not legal advice.

AreaWhat the SOW should stateRisk if omitted
ScopeProcesses, entities, interfaces, reports, data objects, environments, documentation, training, support, and exclusionsBidders and buyer hold different baselines
AcceptanceObjective criteria, evidence, review periods, rejection and cure, deemed-acceptance limits, and signatoryPayment occurs without usable output
AssumptionsNamed owner, due date, consequence, and escalation for each material dependencyUnresolved uncertainty becomes a change order
MilestonesPayment tied to accepted deliverables or sprint outcomesCalendar progress is mistaken for delivered value
Change controlRequest, analysis, authorization, rates, baseline update, and prohibition on unapproved workScope and budget move without informed consent
TeamNamed key people, allocation, location, subcontractors, replacement approval, and handoverThe evaluated team is replaced after award
GovernanceMeeting and demo cadence, inspectable records, risk escalation, decisions, and audit accessDelivery becomes a black box
Architecture and qualityDesign authority, documentation, ALM, test ownership, defect thresholds, security checks, and release approvalTechnical debt and quality disputes surface late
Data and securityAccess, permitted use, privacy, breach duties, residency, subprocessors, retention, return, and deletionControl obligations remain ambiguous
IP and assetsOwnership or licenses for configuration, code, documentation, pipelines, tests, and pre-existing materialsThe buyer cannot operate or transfer the solution
Support and warrantyDefect definition, warranty, service hours, priorities, response, restoration, escalation, and enhancement boundaryPost-launch issues trigger unexpected fees
ExitTermination help, rates, formats, credentials, access transfer, subcontractor duties, and deletion confirmationSwitching providers becomes slow and expensive
PrecedenceOrder among MSA, SOW, proposal, assumptions, security terms, data agreement, and changesConflicting documents weaken commitments

Microsoft recommends Success by Design for Dynamics 365 implementations. Its reviews assess alignment with recommended patterns and help identify implementation risks, while supplementing rather than replacing the partner’s methodology. Ask the bidder to include a Success by Design plan, ownership, timing, inputs, outputs, and remediation path. Also make cutover an executable SOW deliverable. Microsoft’s guidance calls for ordered and timed tasks, primary and backup owners, instructions, verification, sign-off, rollback, rehearsals, and explicit go/no-go criteria.

Make the final decision defensible

Present more than the total. Show points by criterion, evaluator spread, confidence, unresolved risks, normalized price, and contract exceptions. Investigate large scoring differences because they often reveal ambiguous evidence or conflicting interpretations of scope. Run a sensitivity test on the leading bidders by changing only genuinely debatable weights or scores. The purpose is to see whether the result is stable, not to engineer a preferred winner.

Maintain a decision record naming the selected and reserve bidders, main reasons, accepted risks, mitigations, and terms still open. Make the award conditional on named staff, security approval, material architecture or discovery outputs, and agreed SOW terms where needed. A total should inform judgment; it should never overrule a critical unresolved risk.

Copy-ready Dynamics 365 implementation partner scorecard

Copy the table into a spreadsheet. Add one row per bidder or one sheet per bidder. Use the formula weighted points = (raw score ÷ 5) × weight.

CriterionWeightRaw score (0–5)Weighted pointsEvidenceConfidenceRisk or contract action
Business-process and outcome fit14
Product and solution architecture fit13
Discovery, requirements, and scope control11
Data migration, integration, and engineering12
Security, compliance, environments, governance10
Delivery, transparency, and quality10
Team capability, capacity, and continuity9
Adoption, training, and change8
Commercial clarity and contract alignment8
Support, operability, and exit5
Total100/100

Lock weights before bids arrive. Require a source and comment for every raw score. Flag any score below 3 for explicit review if that threshold matches your policy. Keep mandatory gates separate. Normalize commercials against the same scope. Record every proposal commitment that must move into the SOW.

Takeaway: screen risk, score evidence, contract commitments

A sound Dynamics 365 partner selection follows a simple sequence: screen mandatory risks first, score documented evidence second, and contract the winning commitments third. The 100-point model helps a multidisciplinary buying team compare different strengths without averaging away serious concerns. It also creates a record of why a partner was selected and what still needs mitigation.

Adjust the weights before outreach, use the same brief and scenarios for all bidders, and insist on named artifacts and people. The best proposal is not necessarily the most polished or least expensive. It is the one whose claims can be verified, whose remaining risks are understood, and whose promises can survive SOW negotiation.

If your team needs a decision-grade scope before comparing implementation bids, Book a Blueprint Call. Ask QServices IT, or any provider you evaluate, to state exactly what the timeline, fee, deliverables, assumptions, acceptance criteria, and reuse rights cover.

Key Takeaways
  1. Do not begin partner selection with a generic request for "Dynamics 365 implementation services." Bidders will fill the gaps differently, then submit proposals that cannot be compared fairly.
  2. Use a 0–5 raw score for each criterion.
  3. A high total must not hide a failed mandatory condition.
  4. Assess whether the partner understands your target operating model rather than translating a feature list into a module list.
  5. Microsoft partner designations can help form a longlist, but they do not remove diligence.
Rohit Dabra

Written by Rohit Dabra

Co-Founder and CTO, QServices IT Solutions Pvt Ltd

Rohit Dabra is the Co-Founder and Chief Technology Officer at QServices, a software development company focused on building practical digital solutions for businesses. At QServices, Rohit works closely with startups and growing businesses to design and develop web platforms, mobile applications, and scalable cloud systems. He is particularly interested in automation and artificial intelligence, building systems that automate routine tasks for teams and organizations.

Talk to Our Experts

Frequently Asked Questions

There is no universal single criterion. Business-process and outcome fit carries the highest weight in this model, but mandatory security, legal, data-residency, or continuity requirements can override every weighted score. Set priorities before viewing bids based on the program’s specific risk.

No. A Microsoft designation is a useful capability signal, but it does not prove that the named team has the process knowledge, availability, migration discipline, governance, or commercial fit for your implementation. Verify evidence, interview the proposed team, run a scenario, check references, and contract the commitments.

Neither model is automatically safer. Fixed price fits sufficiently defined work. Time and materials can fit discovery or evolving scope when burn, forecasts, caps, priorities, and decisions are transparent. Compare how uncertainty and control are allocated rather than relying on the contract label.

Use a staged process rather than a universal number. Screen a broader longlist against mandatory gates, then retain enough qualified partners to preserve competition while keeping the full RFP, scenario, diligence, reference, and contract review manageable.

It should cover scope and exclusions, deliverables, assumptions, responsibilities, named team commitments, architecture, quality, milestones, acceptance, price and payment, change control, data and security, intellectual property and asset access, support, warranty, exit assistance, and document precedence.

Related Topics

Mid-market IT leaders reviewing a governed business intelligence architecture and Power BI dashboards - business intelligence consulting services

Business Intelligence Consulting Services for Mid-Market

Business Intelligence Consulting Services for Mid-Market Rohit Dabra | Updated on September 13, 2026 Table of Contents Facebook-f Twitter Linkedin Summarize in: Get an instant AI summary of this article OpenAI Perplexity Claude Introduction Business intelligence consulting services should give a mid-market company a governed way to make decisions. Attractive dashboards are only the visible part. The useful outcome is a system in which source data, metric definitions, access, releases,

Microsoft Solutions Partner vs Microsoft Partner designation comparison for IT procurement leaders

Microsoft Solutions Partner vs Microsoft Partner

Microsoft Solutions Partner vs Microsoft Partner Rohit Dabra | Updated on September 13, 2026 Table of Contents Facebook-f Twitter Linkedin Summarize in: Get an instant AI summary of this article OpenAI Perplexity Claude Introduction   In a Microsoft Solutions Partner vs Microsoft Partner comparison, the difference is validation. A company can participate in the Microsoft AI Cloud Partner Program without holding a customer-facing Solutions Partner designation. A designated Solutions Partner

Enterprise architects planning a legacy application modernization strategy for Microsoft Azure

Legacy Application Modernization Strategy for Azure

Legacy Application Modernization Strategy for Azure Rohit Dabra | Updated on September 12, 2026 Table of Contents Facebook-f Twitter Linkedin Summarize in: Get an instant AI summary of this article OpenAI Perplexity Claude Introduction A legacy application modernization strategy assigns the right treatment to each workload, then sequences the work around business value, technical evidence, and operational risk. For Azure, that means choosing among retire, retain, rehost, replatform, refactor, rearchitect,

Eager to discuss about your project?

Share your project idea with us. Together, we’ll transform your vision into an exceptional digital product!

Book an Appointment now

Globally Esteemed on Leading Rating Platforms

Earning Global Recognition: A Testament to Quality Work and Client Satisfaction. Our Business Thrives on Customer Partnership

5.0

5.0

5.0

5.0

Turn the Microsoft Licenses
You Already Own Into an
AI Workplace

Join our live webinar on Sept 24 and see five
ways to automate meetings, approvals, and

document search with  tools already in your

tenant.

Assured
Thank You

Your details has been submitted successfully. We will Contact you soon!
